Simulation-based safety evaluation model integrated
with network schedule
Wei-Chih Wang *, Jang-Jeng Liu, Shih-Chieh Chou
Department of Civil Engineering, National Chiao Tung University, 1001, Ta-Hsueh Road, Hsin-Chu 300, Taiwan Accepted 7 June 2005
Abstract
Construction accidents often lead to project delays. However, in practice, construction safety and schedule control are managed separately. This work develops an innovative simulation-based model, SimSAFE, that assesses the hazard (or expected accident costs) for each activity in a network schedule. Thus, at any time point, safety managers can pay considerable attention to activities (or paths or working zones) with high expected accident costs. Additionally, by breaking down the uncertainty of an accident cause occurring, SimSAFE provides factor-sensitivity information to support safety risk management. Enhancing knowledge of the safety factors (such as safety training and site environment) to which an activity (or path or zone) is sensitive, and also of the activities (or paths or zones) that are most sensitive to a particular factor can provide management with a better sense of what factors and activities (or paths or zones) need to be controlled for reducing construction accidents, especially for a large project or multiple projects.
D 2005 Elsevier B.V. All rights reserved.
Keywords: Construction safety; Accident cost; Schedule control; Uncertainty; Simulation
1. Introduction
The construction industry is statistically one of the most
hazardous industries in many countries[1 – 3]. For example,
in Taiwan, approximately 60% of fatal accidents in all industries between 1999 and 2001 arose in the construction
industry [4]. Besides causing human tragedy, construction
accidents also delay project progress, increase costs, and damage the reputation of the contractors. Therefore, appropriate safety planning that meets governmental safety regulations is an essential task before commencing con-struction work. During concon-struction, contractors are asked to employ qualified safety specialists, assemble temporary safety facilities (for example, falsework and electricity), provide safety machinery/equipment (for example, cranes and excavators), supply safeguards (for example, safety signals, safety nets, and fire extinguishers), provide personal
protective equipment (for example, hard hats, safety shoes, safety belts, and hearing protection), and provide workers with adequate safety instructions before allowing them on the jobsite.
However, most contractors simply see their safety plans as a burdensome necessity for avoiding government fines,
and neglect their implementation[5]. The implementation of
safety plans is frequently regarded as an extra task. Several safety professionals have realized that improving safety performance requires integrating safety with construction
planning and control [5,6]. Namely, safety management
must be treated with the same kind of thoughtful project planning and control that goes into other aspects of project management.
This study proposes a simulation-based model, Sim-SAFE, that incorporates safety management into schedule control. Specifically, the degree of hazard (or expected accident costs) of each activity in a construction project is evaluated; and this evaluation information is attached to the project network schedule. Simulation algorithms are used to consider uncertainties (uncertain safety factors) that are 0926-5805/$ - see front matterD 2005 Elsevier B.V. All rights reserved.
doi:10.1016/j.autcon.2005.06.015
* Corresponding author. Tel.: +886 35712121x54952; fax: +886 35716257.
E-mail address: [email protected] (W.-C. Wang).
often ignored in safety management. The anticipated advantages of attaching safety information to project schedules are to increase knowledge of the factors to which an activity (or path or zone) is sensitive, and those that are most sensitive to a particular factor. As a result, manage-ment can better understand what factors relating to each activity (or path or zone) and of what activities (or paths or zones) to control to reduce construction accidents.
The methodology used in this investigation comprises the following phases: (1) review relevant research to identify the focuses of existing studies; (2) define the factors and the degree of hazard of construction activities; (3) present the SimSAFE model to evaluate the degree of hazard of each activity of a network schedule; (4) illustrate the detailed modeling steps using a two-activity network; (5) demonstrate model operation through application to an example project; and (6) elucidate the advantages of the model and recommend future research directions.
2. Pertinent research
Extensive research has been conducted to improve construction safety. It can be separated into the following seven categories.
Identifying root causes of injuries—for example, Hinze et al. suggested coding injuries into one of 20 possible categories of accident causes, instead of the conventional five groups of falls, struck-by, electric shocks, caught in/
between, and others[7].
Identifying factors or strategies that influence safety performance—in the UK, Sawacha et al. identified that the five most important factors or strategies associated with site safety were management talks on safety, provision of safety booklets, provision of safety equip-ment, provision of safety environequip-ment, and appointment
of a trained safety representative on site [8]. Using a
questionnaire survey, Fang et al. analyzed the correla-tions between the safety factors and safety management
performance[9].
Examining the usefulness of various safety performance measures—considering the effectiveness of a method of measuring safety performance, Laufer and Ledbetter investigated various measurement methods and con-cluded that the most effective measures were lost-day cases, doctor’s cases, and cost of accidents[10]. Hinze et al. focused on a widely-used method, experience modification rating (EMR), for clarifying the effect of
different variables on the EMR values[11]. Their results
demonstrated that injury frequency impacted the EMR computation more than injury severity. Based on a survey
by de la Garza et al. [12], ‘‘what gets measured, gets
improved.’’
Designing strategies for improving safety performance— using a behavioral approach, Duff et al. showed that
safety behavior can be objectively measured; goal setting and feedback interventions could significantly improve safety performance; and commitment of site managers
could enhance intervention effectiveness [13]. Owing to
the limitations of each measure of safety performance (including EMR and recordable incident rate), Jaselskis et al. created a questionnaire asking questions regarding the combination of measures that gave the best overall indication of safety performance at both the company and project levels[14].
Estimating the costs of accidents and injuries—Hinze and Appelgate displayed that the indirect costs often substantially exceeded the direct costs for construction
injuries [15]. Everett and Frank demonstrated that the
costs associated with accidents and injuries have risen from 6.5% of construction costs in 1982 to between 7.9%
and 15% in 1995[16]. Meanwhile, indirect costs, which
were less tangible, included those costs associated with loss of productivity, administrative time for investiga-tions and reports, cleanup, repairs, etc.
Addressing construction worker safety in the design phase—considering that designers generally lack the relevant knowledge and thus their involvement in construction safety is limited, Gambatese and Hinze accumulated design suggestions for developing a tool to assist designers in identifying project-specific safety hazards and providing suitable practices for eliminating
construction accidents [17].
Integrating safety concerns with other management plans—for instance, Saurin et al. devised a model to integrate safety into three hierarchical levels (namely, long-term, medium-term, and short-term) of production
planning[5]. Long-term safety planning started with the
preliminary hazard analysis of construction processes. The long-term plans were updated and detailed at both medium (tri-weekly)- and short-term (daily or weekly) planning levels. The major performance measure adopted for safety assessment during the short-term was the percentage of work packages that were completed safely. Kartam designed a framework for a computerized safety and heath knowledge-intensive system that was inte-grated with current critical-path-method (CPM)
schedul-ing software[6]. In this framework, extensive safety data
and knowledge (including knowledge required by law and gathered from professionals) were coded and stored in a database system which was linked to CPM project files.
In summary, the area of research that is most relevant to this work concerns the integration of safety considerations into management plans. The model of Saurin et al. combines safety control functions with existing production planning and control processes. They regarded safety planning and
control as a broad managerial process [5]. However, as
stated by Saurin et al. [5], their model did not formally
accidents. Also, their safety planning and control were not integrated with schedule control. The framework proposed by Kartam sought primarily to reduce the time spent searching through volumes of safety regulations using a computerized system, allowing safety information specific
to individual activities to be accessed [6]. Namely, the
framework did not provide a proactive safety alert (to indicate which activities are more hazardous than others).
3. Factors and degrees of hazard
During construction activity execution, one or several accident causes (simply termed ‘‘causes’’ herein) are likely to occur. Several factors influence the likelihood of a cause occurring during the execution of a particular activity. If factor performance strongly influences the likelihood of a cause occurring during an activity, then management had better pay attention to the effective management of the factor for the activity. Typical safety factors include safety training, site environment, subcontractor safety management ability, and safety inspection. For instance, the likelihood of occurrence of ‘‘falls from elevated position’’ is highly sensitive to the safety training of the workers who perform the steel-erection activity. Namely, inexperienced or poorly trained workers likely lack the safety knowledge required to minimize the risk of falling from high working places. Since factor performance is uncertain, this work treats factors as uncertainty variables.
No accidents occur without there first being a cause. When there is a cause (for example, a laborer falls from an elevation), workers may suffer different degrees of injury (such as, light injury, medium injury, severe injury, disabling injury, or death) and additional costs may be required to deal with the accident. These resulting costs are here called accident costs. (The accident costs are detailed in Section 4.2.1.)
The expected accident cost of activity i due to various causes is termed the degree of hazard of activity i, denoted as Hi; and is represented as
Hi¼ hi 1ð Þþ hi 2ð Þþ N þ hi jð Þþ N þ hi Jð Þ ð1Þ
in which hi( j) denotes the degree of hazard (expected
accident cost) resulting from cause j ( j = 1,. . ., J) for activity i. In Taiwan, 15 categories of causes (categories A – O) are commonly used to record accident data. The categories of causes include falls from elevation (A), falls from ground level (B), collisions (C), strikes from falling materials (D), strikes from collapsed objects (E), strikes from equipment (F), caught in/between (trapping by) equipment or material (G), stabbing or slashing (H), trampling (I), burning by high or low temperature materials (J), poisoning by toxic substances (K), electric shock (L), explosion (M), striking by breaking objects (N), and fire (O).
4. SimSAFE model

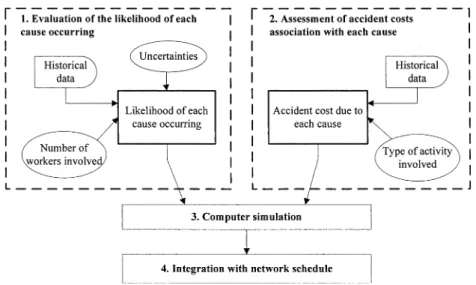

SimSAFE evaluates the degree of hazard of each activity
according to the following four steps (see Fig. 1): (1)
evaluating the likelihood of each cause occurring; (2) assessing the accident costs associated with each cause; (3) applying computer simulation for dealing with uncer-tainties; and (4) integrating safety information with the network schedule. The algorithms used for each step are detailed below.
Notably, in this investigation, the occurrence of a cause depends on the ‘‘likelihood’’ of such a clause occurring. Moreover, this ‘‘likelihood’’ is a variable represented by a distribution of likelihood (a pool of possible likelihood values). Factors affect the distribution of such a variable. A particular likelihood value is picked in a given run (or iteration), depending on how simulation draws from the distribution. For example, if simulation randomly draws a
value of 0.6 from a distribution as the likelihood of a cause occurring, this value of 0.6 then indicates a 60% chance that the cause will occur, and a 40% chance that the cause will not occur. The following section illustrates such a distribu-tion of likelihood.
4.1. Evaluating the likelihood of each cause occurring For each activity, the distribution of the likelihood of a particular cause occurring is determined based on a reference likelihood and the effects of factors on that likelihood.
4.1.1. Establishing the base likelihood for each accident cause
The reference likelihood of a specific cause occurring is derived from historical data. This reference likelihood
(REFj) of cause j is defined as the total number of
construction workers injured owing to cause j in 1 year divided by the total number of construction workers registered with the Taiwan Council of Labor Affairs (CLA) in that year. The Taiwan CLA, the highest governmental agency responsible for occupational safety and health, possesses an annual collection of historical data
required to calculate REFj [4]. Notably, the reference
likelihood of a cause (calculated from historical data) is used as a basis for assisting the model user in evaluating the likelihood of the cause’s occurring in association with a particular activity.Table 1lists the likelihood of each cause occurring, on a per worker basis.
For example, 2581 workers were injured because of cause A (falls from evaluation) in 2000; and 722,238 workers were registered with the CLA during the same year. Therefore, the reference likelihood of cause A occurring per worker is 0.0035736 ( = 2581/722,238). Namely, 3.5736 workers could be injured per thousand workers. Activity
execution involves multiple workers. Accordingly, the reference likelihood of cause j should be further multiplied by the number of workers performing the activity. In the above example, if ten workers are involved in an activity, then the likelihood of cause A occurring for that activity
equals 0.0035736 10 = 0.035736.
4.1.2. Deriving an overall distribution of the likelihood for each cause
Three-point estimation is adopted to obtain the overall distribution ( Fi( j)) of each cause j occurring for an activity
i. The mean (Mi( j)) and standard deviation (ri( j)) of this
overall distribution are derived as[18], Mi jð Þ¼ li jð Þþ 4ti jð Þþ ui jð Þ 6 ð2Þ ri jð Þ¼ ui jð Þ li jð Þ 3:2 ð3Þ
where li( j), ti( j) and ui( j) denote the optimistic (or low),
most likely and pessimistic (or high) likelihoods of Fi( j)due
to cause j for activity i, respectively (i = 1, 2, . . ., I and j = 1, 2,. . ., J).
The derived reference likelihoods listed in Table 1 are
used to help establish the distribution of Fi( j). For practical
considerations, a multiplier system is proposed to help determine the three-point estimations such that the model

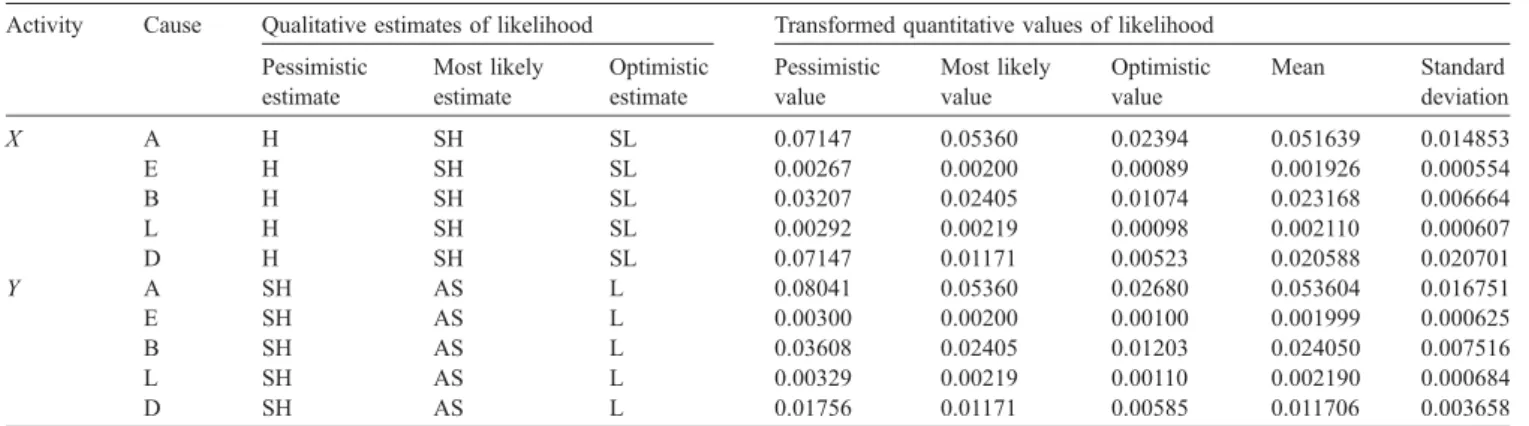

user needs only provide qualitative inputs.Table 2shows an
example of such a multiplier system including seven multipliers, each corresponding to a particular qualitative estimate. In the previous example, if the qualitative estimate of pessimistic value because of cause A for activity i is determined to be ‘‘higher than’’ the reference likelihood,
then the derived pessimistic likelihood (ui( j)) = reference
likelihood number of workers involved a corresponding
multiplier = 0.0035736 10 2.0 = 0.071472. Notably, the
model user can define their multiplier system using varying multiplier values.
4.1.3. Breaking down the overall distribution
Each overall distribution ( Fi( j)) is disaggregated as the
sum of a deterministic base likelihood and a series of zero-mean sub-distributions (called factor distributions) due to various factors. Additionally, each factor distribution with respect to a particular factor is further broken down into a family of several sub-sub-distributions (called factor-con-dition distributions) representing the uncertainty resulting from a specific condition (such as, good, normal, or bad) of
the factor. Fig. 2 illustrates the two breakdowns of
uncertainty for Fi( j). Notably, the model user determines
the number of factors involved and the number of factor-condition distributions in a family.
Mathematically, Fi( j), a random variable, is represented
by[19]
Fi jð Þ¼ fi j;0ð Þþ fi j;1ð Þþ N þ fi j;Kð Þ ð4Þ
Table 1
Reference likelihood associated with each cause of accidents per worker
Accident causes Number of workers
injured in a year
Reference likelihood
A. Falls from elevation 2581 0.0035736
B. Falls from ground level 1158 0.0016033
C. Collisions 99 0.0001371
D. Strikes from falling material 620 0.0008584
E. Strikes from collapsed objects 154 0.0002132
F. Strikes from equipment 446 0.0006175
G. Caught in/between equipment or material
1644 0.0022763
H. Stabbing or slashing 1892 0.0026196
I. Trampling 19 0.0000263
J. Burning by high or low temperature materials
167 0.0002312
K. Poisoning by toxic substances/gas 40 0.0000554
L. Electric shock 116 0.0001606
M. Explosion 35 0.0000485
N. Striking by breaking objects 4 0.0000055
where fi( j,0)denotes the base likelihood estimated under the
expected conditions of all factors. The random variable, fi( j,k), is the factor distribution of cause j because of factor k
(k = 1, . . ., K) for activity i.
The expected values of the factor distributions are assumed to be zero; mi( j,1)= mi( j,2)= . . . = mi( j,K)= 0. fi( j,1),
fi( j,2), . . ., and fi( j,K)are assumed to be independent of one
another. Then, regardless of the statistical distribution of fi( j,k), the mean (mi( j)) and variance (r2i( j)) of Fi( j) are as
follows[19,20]: Mi jð Þ¼ mi j;0ð Þþ mi j;1ð Þþ mi j;2ð Þþ N þ mi j;Kð Þ ¼ mi j;0ð Þ ð5Þ r2i jð Þ¼ SD2 i j;0ð Þþ SD2i j;1ð Þþ SD2i j;2ð Þþ N þ SD2i j;Kð Þ ¼ SD2 i j;1ð Þþ SD2i j;2ð Þþ N þ SD2i j;Kð Þ ð6Þ
where SD2i( j,k) denotes the variance of fi( j,k); SD2i( j,0)=0.
Restated, the mean of Fi( j) is its base likelihood, and the
variance of Fi( j)is the sum of the variances of individual
factor distributions.
4.1.4. Deriving factor distribution
The overall distribution is broken down into several factor distributions based on subjective information. That is, for each activity, the model user must qualitatively estimate the sensitivity of each factor on each cause occurring. If cause j is highly sensitive to a specific factor k, a large portion of the variance (r2i( j)) of the overall distribution due
to cause j is then allocated as the variance of the factor distribution owing to factor k.
A scale system is devised for allocating the variance of the overall distribution to the factor distributions. Namely
[19,20],
r2i jð Þ¼ SD2i j;1ð Þþ SD2i j;2ð Þþ N þ SD2i j;Kð Þ ð7aÞ
¼ w 1Qi j;1ð Þþ w2Qi j;2ð Þþ N þ wKQi j;Kð Þ
Yi jð Þ ð7bÞ
SDi j;k2ð Þ¼ wkQi j;kð Þ Yi jð Þ ð8Þ
where Qi( j,k)denotes the qualitative estimate of cause j for
factor k. Moreover, wk[ Qi( j,k)] represents a scale of each
Overall distribution Factor distribution Worse-than-expected condition Better-than-expected condition Expected condition Factor-condition distribution
Base likelihood Factor 3
°œ° Mean = base likelihood Due to all factors
Mean = 0 SDi(j,3) Mean = 0 SDi(j,2) Factor 2 + + + + Mean = 0 SDi(j,1) Factor 1
Mean = base likelihood SDi(j,0) = 0
...
Fig. 2. Two breakdowns of the overall distribution of the likelihood associated with each cause. Table 2
Multiplier system to transfer qualitative estimates of likelihood Qualitative estimates Extremely higher
than (EH) Higher than (H) Slightly higher than (SH) Almost the same as (AS) Slightly lower than (SL) Lower than (L) Extremely lower than (EL) Multiplier 2.5 2 1.5 1 0.67 0.5 0.4
level of influence. If Qi( j,k) represents a high level of
in-fluence,then wk[ Qi( j,k)] is great. The relative importance of
factors determines the value of wk[ Qi( j,k)]. Yi( j)is an
adjust-ment constant that ensures that the variance (r2i( j)) is
main-tained. The value of wk[ Qi( j,k)] remains the same for each
factor and level of influence, so Yi( j)differs for each cause.
4.1.5. Deriving child distributions
In the second breakdown of uncertainty (seeFig. 2), the
mean (mi( j,k)) and variance (SD2i( j,k)) of the factor
distribu-tion equal the mean and variance of the combinadistribu-tion of the factor-condition distributions for a family, respectively.
Mathematically, this relationship is given by[19,20]
mi j;kð Þ¼ 0 ¼ XC c¼1 pj;k cð Þ oi;j k c½ð Þ ð9Þ SD2i j;kð Þ¼ X C c¼1 pj;k cð Þ sd2i;j k c½ð Þþ o2i;j k c½ð Þ ð10Þ where C denotes the number of factor-condition distribu-tions, and pj,k(c)represents the probability of occurrence of
factor-condition distribution c of factor k for cause j. The mean and standard deviation of the factor-condition distribution c of factor k associated with cause j for activity i are oi,j[k(c)]and sdi,j[k(c)], respectively.
4.2. Assessing the accident costs associated with each cause In the event of an accident, the resulting accident cost depends on the type of injury. This section illustrates the accident cost for each type of injury, the chance of each type of injury occurring, and the expected accident cost (the degree of hazard) due to each cause for each activity. 4.2.1. Accident cost for each injury type
The five-type injury classification system used by the Institute of Occupational Safety and Health (IOSH) in Taiwan is adopted in this study. This system classifies injuries as light (represented by t1), medium (t2), severe (t3), disabling (t4), and fatal (t5)[21]. Based on the accident cost data presented by IOSH, the average accident costs per accident for injury t (t = t1 – t5) for a specific cause j, Costt( j), are estimated and listed inTable 3.Table 3lists the
accident costs in New Taiwan dollars, hereafter referred to as NT dollars. (1 US dollar ; 32 New Taiwan dollars.)
Accident costs include both direct and indirect costs. The direct costs were estimated using historical data collected by
IOSH between 1991 and 1993 [21]. Moreover, the direct
costs per accident consisted of the compensation (e.g., wages paid to the injured workers for time not worked and consolation money) paid by the contractor to the injured workers, plus any compensation (e.g., cash payments to the injured workers and medical care) paid by the public liability insurance (namely, the Bureau of Labor Insurance
of Taiwan). Notably, the analysis presented in Table 3
excluded compensation from private insurance companies. The indirect costs per accident included the costs of accident investigation, legal fees, training costs for replacement workers, equipment and materials damage, lost profits, and costs associated with loss of productivity (if any). These costs, which are comparatively difficult to quantify, were estimated by interviews (or sometimes questionnaires) with
over 70 Taiwanese contractors [21].
The accident costs listed in Table 3 are calculated as
follows. For example, the per accident cost of light injury for cause A is
NT$15; 000¼ direct costs þ indirect costs
¼ direct costs per lightly injured workerð
average number of workers injured due to cause AÞ þ indirect costs per accident
¼ $3000 worker per accidentð Þ
þ 12; 000:
The figures of $3000 and $12,000 were obtained from IOSH. Moreover, the average number of workers injured was estimated based on the 3-year historical accident data
from the Taiwanese Council of Labor Affairs [4]. Namely,
the average number of workers injured owing to a particular cause was the total number of workers injured due to that cause during a 3-year period divided by the number of accidents because of that cause during that period. For example, the average number of workers injured due to cause A was one person per accident. (Notably, the accident
cost data listed in Table 3 can be updated if additional
historical data are collected. It is suggested that future research can conduct this updating work.)
4.2.2. Chance of each type of injury arising
The chance of a particular type of injury occurring following the occurrence of a particular cause can vary in executing different activities. For practicality, the model user Table 3
Cost of accident of each type of injury for each cause Causes Accident costs (in thousand, NT dollars)
Light injury Medium injury Severe injury Disabling injury Death A 15 158 461 1093 2143 B 10 167 730 538 2143 C 6 68 665 311 2143 D 16.1 192.5 713.8 1151 2294.8 E 32.8 223 681 1615 3053.8 F 6.2 77.2 688.4 240 2446.6 G 6 141 653 381 2143 H 11 50 261 336 2143 I 9 62 494 168 2143 J 10.5 132 983 448 2143 K 11 98 757 309 2143 L 21.5 159.8 1201 657.6 2294.8 M 52.2 281.4 825 1187 3357.4 N 21.5 193 187.5 582.5 2902 O 56.3 252.1 742 1769 2598.4
qualitatively assesses the chances of various types of injury occurring, then transfers these qualitative assessments to quantitative values. A possible set of quantitative values for various qualitative estimates is very high (VH) = 5; high (H) = 4; medium (M) = 3; low (L) = 2; and very low (VL) = 1. For example, assume that the chances of light injury, medium injury, severe injury, disabling injury, and fatal injury
occurring following the occurrence of cause A in association with a particular activity are qualitatively estimated as follows: VL, L, L, H and VH, respectively. The chances of these five types of injuries occurring following the occur-rence of this cause then are 1/14 (= 1/(1 + 2 + 2 + 4 + 5)), 2/14, 2/14, 4/14, and 5/14, respectively. Notably, the model user is permitted to define their quantitative values.

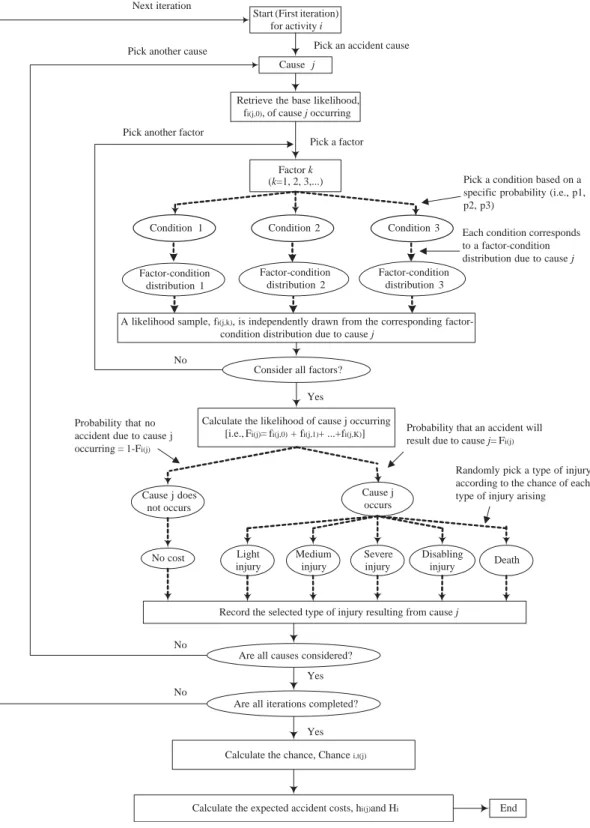

Start (First iteration) for activity i
Factor k (k=1, 2, 3,...)
A likelihood sample, fi(j,k), is independently drawn from the corresponding
factor-condition distribution due to cause j
Consider all factors? Condition 1 Factor-condition distribution 3 Factor-condition distribution 2 Condition 3 Condition 2 Factor-condition distribution 1
Calculate the likelihood of cause j occurring [i.e., Fi(j)= fi(j,0) + fi(j,1)+ ...+fi(j,K)]
Record the selected type of injury resulting from cause j
Are all causes considered?
Are all iterations completed?
Calculate the expected accident costs, hi(j)and Hi
No Yes No No Yes Yes
Pick an accident cause
Pick a factor Pick another factor
Pick a condition based on a specific probability (i.e., p1, p2, p3)
Each condition corresponds to a factor-condition distribution due to cause j
Calculate the chance, Chance i,t(j)
Cause j occurs Light injury Severe injury Death Disabling injury Medium injury Cause j does not occurs No cost
Randomly pick a type of injury according to the chance of each type of injury arising Probability that an accident will result due to cause j= Fi(j)
Cause j
Retrieve the base likelihood, fi(j,0), of cause j occurring Next iteration
Pick another cause
Probability that no accident due to cause j occurring = 1-Fi(j)
End
4.2.3. Expected accident cost for each cause
The expected accident cost owing to cause j in association with activity i, hi( j), is calculated as follows
hi jð Þ¼ Xt5 t¼t1
Chancei;t jð Þ Costt jð Þ
ð11Þ where Chancei,t( j)is the chance of injury t occurring due to j
for activity i following a certain number of simulation iterations. See Section 4.3. Chancei,t( j)is determined based
on the likelihood of a cause j ( Fi( j)) occurring, and the
chance of a particular injury t (refer to Section 4.2.2) arising in association with activity i. Costt( j), listed inTable 3, is the
average cost per accident for injury t given a specific cause j. 4.3. Computer simulation
Fig. 3 shows the implementation strategy of the SimSAFE model. The following steps are executed during each simulation iteration for activity i.
& The base likelihood ( fi( j,0)) of each cause j occurring is
retrieved.
& A condition is selected for each factor k in association with each cause j based on a specific probability ( pj,k(c))
that the condition applies.
& A likelihood sample ( fi( j,k)) is independently drawn from
the factor-condition distribution corresponding to the condition for cause j.
& After processing all the conditions of each factor, the overall distribution ( Fi( j)) associated with each cause j is
determined by summing its base likelihood and varia-tions resulting from each factor condition. See Eq. (4). & The probability that an accident will result due to cause j
then is Fi( j). Meanwhile, the probability of no accident
occurring owing to cause j is 1 Fi( j). The model
randomly determines whether an accident will occur because of cause j.
& No accident cost results if no accident occurs due to cause j. If an accident does occur owing to cause j, a particular type of injury t then is determined (see Section 4.2.2). At this step, the selected type of injury resulting from cause j is recorded.
& The above steps are repeated for all causes.
Following all iterations are considered, the chance
(Chancei,t( j)) that a particular injury t due to cause j in
association with activity i is calculated. Subsequently, the
expected accident costs owing to cause j (hi( j)) and due to
all causes (Hi) for each activity can be obtained based on
Eqs. (11) and (1), respectively.
A simulation language, Stroboscope [22], was used to
implement the simulation-relevant algorithms described herein. Stroboscope can dynamically access simulation state and includes an add-on that enables the definition of CPM networks with stochastic variables (for example, the
occur-rence of a cause) and the calculation of various statistics regarding the activities, paths, working zones and project. In this investigation, Stroboscope was run in the Windows 2000 environment, with a P3 850 CPU and 256 Mega Ram. Approximately 1 min was required to run 1000 iterations. 4.4. Integration with CPM network
The simulated likelihood of each cause ( Fi( j)) occurring
and the expected accident costs (hi( j)and Hi) for each activity
are attached to the schedule network. Then, the sensitivities of paths (or zones) to uncertainties are assessed. The uncertainty sensitivity of factor k on a particular path for cause j is measured using the Coefficient of Variation (CV) of the occurrence of an accident along path. A path is considered highly sensitive to a factor if it has a high CV value for that factor. High factor sensitivity along a path indicates that the occurrence of an accident due to cause j for the path is strongly affected by change in that factor. Mathematically, the value of CV of a path for factor k, CVpath,k, is
CVpath;k ¼ PSDpath;k=Meanpath ð12Þ
in which Meanpathdenotes the mean occurrence of accident
due to all causes for all factors along a path, and PSDpath,kis
the standard deviation of accident occurrence due to all causes along a path when only factor k is assessed.
Similarly, the uncertainty sensitivity for factor k in a
working zone (CVzone,k) is as follows.
CVzone;k ¼ ZSDzone;k=Meanzone ð13Þ
where Meanzonedenotes the mean accident occurrence due
to all causes for all factors within a zone; and ZSDzone,k
represents the standard deviation of accident occurrence due to all causes within a specific zone when only factor k is assessed.
5. Model operation using a two-activity network This section illustrates the input operations for SimSAFE using a two-activity small network; activities XYY. Ten and 15 workers are involved in executing activities X and Y, respectively. Five accident causes are considered, including causes A, B, D, E, and L. Moreover, three factors are considered, including factors F1, F2, and F3.
5.1. Inputs
5.1.1. Input 1: providing three-point estimations of likelihoods
The model user qualitatively provides the optimistic likelihood (li( j)), most likely likelihood (ti( j)), and
pessi-mistic likelihood (ui( j)) for each cause j in association with
each activity i. Each qualitative estimate is then transformed to a quantitative value based on a multiplier system listed in
Table 2. Take cause A for activity X for example. If the qualitative estimates of li( j), ti( j), and ui( j) are ‘‘higher,’’
‘‘slightly higher,’’ and ‘‘slightly lower’’ than the reference likelihood, respectively, then the quantitative values of the
likelihoods for cause A are 0.07147 (= 2 0.0035736 10),
0.05360 (= 1.5 0.0035736 10), and 0.02394 (= 0.67
0.0035736 10), respectively. Table 4 lists the values of
li( j), ti( j), and ui( j)for each cause in association with each
activity. Additionally, the mean and standard deviation of the overall distribution are calculated using Eqs. (2) and (3)
and are also displayed on the right ofTable 4.
5.1.2. Input 2: providing qualitative factor sensitivities
Table 5 lists the sensitivity of each factor on the occurrence of each cause for each activity. For example, factors F1, F2 and F3 have high, low and medium sensitivities to the occurrence of cause A for activity X, respectively.
5.1.3. Input 3: estimating the chance of each type of injury arising
Table 6 lists the qualitative estimates and calculated values of the chance of each type of injury occurring. For example, in cause A, the qualitative estimates of the chances of occurrence for light injury, medium injury, severe injury, disabling injury, and fatal injury are very low (VL), low (L),
low (L), high (H) and very high (VH), respectively. Then, based on a transforming system (VL = 1, L = 2, H = 4 and VH = 5), the quantitative chances of the five types of injury occurring owing to cause A are light injury = 1/(1 + 2 + 2 + 4 + 5) = 0.07; medium injury = 2/(1 + 2 + 2 + 4 + 5) = 0.14; severe injury = 2/(1 + 2 + 2 + 4 + 5) = 0.14; disabling injury = 4/(1 + 2 + 2 + 4 + 5) = 0.29; fatal injury = 5/(1 + 2 + 2 + 4 + 5) = 0.36. These qualitative inputs can vary according to cause and activity.
5.2. Calculating the factor and factor-condition distributions
In SimSAFE, the simulation algorithm is run to determine the likelihood of a particular cause occurring based on the families of factor-condition distributions.
Deriving the mean (oi ,j [k (c )]) and standard deviation
(sdi,j[k(c)]) of a family of factor-condition distributions
requires first determining the variance (SD2i( j,k)) of the
factor distribution ( fi( j,k)). Take cause A for activity X for
example. SD2i( j,k) is determined follows. (Table 7 lists the
calculated r2i( j)and SD 2
i( j,k)for each factor distribution).
& Since the standard deviation (ri ( j )) of the overall
distribution equals 0.014853 (see Table 4), then
r2i( j)= 0.014853 0.014853 = 0.0002206. Table 4
Three-point estimates of the likelihood of each cause (two-activity example)
Activity Cause Qualitative estimates of likelihood Transformed quantitative values of likelihood Pessimistic estimate Most likely estimate Optimistic estimate Pessimistic value Most likely value Optimistic value Mean Standard deviation X A H SH SL 0.07147 0.05360 0.02394 0.051639 0.014853 E H SH SL 0.00267 0.00200 0.00089 0.001926 0.000554 B H SH SL 0.03207 0.02405 0.01074 0.023168 0.006664 L H SH SL 0.00292 0.00219 0.00098 0.002110 0.000607 D H SH SL 0.07147 0.01171 0.00523 0.020588 0.020701 Y A SH AS L 0.08041 0.05360 0.02680 0.053604 0.016751 E SH AS L 0.00300 0.00200 0.00100 0.001999 0.000625 B SH AS L 0.03608 0.02405 0.01203 0.024050 0.007516 L SH AS L 0.00329 0.00219 0.00110 0.002190 0.000684 D SH AS L 0.01756 0.01171 0.00585 0.011706 0.003658
H—higher; SH—slightly higher; AS—almost the same as; L—lower than.
Table 5
Sensitivities of each factor to each cause (two-activity example)
Activity Cause Factor sensitivity
F1 F2 F3
X A High Low Medium
E High Medium Medium
B Medium Medium Medium
L Low Low High
D Medium Low Low
Y A Medium Low High
E High Medium Medium
B Medium Low High
L High Medium Medium
D Medium Low High
Table 6
Qualitative and quantitative estimates of the chance of each type of injury occurring (two-activity example)
Cause Chance Light injury Medium injury Severe injury Disabling injury Death A VL (0.07) L (0.14) L (0.14) H (0.29) VH (0.36) E VL (0.08) L (0.15) M (0.23) M (0.23) H (0.31) B VL (0.08) VL (0.08) M (0.23) H (0.31) H (0.31) L VL (0.08) L (0.17) L (0.17) M (0.25) H (0.33) D L (0.13) M (0.19) L (0.13) H (0.25) VH (0.31)
VL—very low; L—Low; H: high; VH: very high; M—medium. The bracketed value represents the quantitative estimate of the chance of each type of injury arising.
& As indicated inTable 5, factors F1, F2 and F3 have high, low and medium sensitivities to cause A occurring for activity X, respectively. The following values are
assumed: wF 1[high] = 8, wF 1[low] = 1, and wF 1
[me-dium] = 5. Then, ~Kk¼1Wk Qi j;kð Þ
¼ 8 þ 1 þ 5 ¼ 14.
& Based on Eq. (7a) (7b), Yi ( j )= 0.0002206 14 =
0.00001576.
& Based on Eq. (8), SD2i ( j , F 1 )= 8 0.00001576 =
0.00012606; SD2i ( j ,F 2)= 1 0.00001576 = 0.00001576;
and SD2i( j,F3)= 5 0.00001576 = 0.00007879.
Assume that the user chooses the categories better-than-expected, as-better-than-expected, and worse-than-expected to describe the conditions of the factor (F1). A family of three factor-condition distributions can then be constructed. Assume that the factor-condition distributions all have equal probabilities
of occurrence. Restated, p1= p2= p3= 1/3. The following
relationships thus can be identified based on Eqs. (9) and (10):
1=3
ð Þo1þ 1=3ð Þo2þ 1=3ð Þo3¼ 0 ð14Þ
1=3 ð Þ sd2 1þ o21 þ 1=3ð Þ sd2 2þ o22 þ 1=3ð Þ sd2 3þ o23 ¼ 0:00012606: ð15Þ
Assume o1= o3= x and o2= 0 so that Eq. (14) is
satisfied. Let the factor-condition distributions have equal standard deviations. Eq. (15) then can be rewritten as
sd2þ 2=3ð Þx2¼ 0:00012606: ð16Þ
The limit of the value of x is determined by requiring the variance of the factor-condition distribution to be non-negative. That is,
sd2¼ 0:00012606 2=3ð Þx20: ð17Þ
Thus, the limit in this case is x 0.013751 (limit =
0.013751). Namely, the values 0.013751 and 0.013751
are the two extreme means for factor-condition distributions one and three, respectively. The next step is to assign x a value between 0 and 0.013751. Rather than specifying the exact value of x, the SimSAFE model suggests selecting the value of x based on the level of factor sensitivity. For
example, o3 has the values 0.7 Limit, 0.5 Limit, and 0.3
Limit for high, medium, and low levels of influence, respectively. In this example (high level of influence), x is set to 0.7 Limit = 0.009626. Thus, the properties of the three
factor-condition distributions are p1= 1/3, o1= 0.00963,
sd1= 0.00802; p2= 1/3, o2= 0, sd2= 0.00802; and p3= 1/3,
o3= 0.00936, sd3= 0.00802. Table 8 lists the properties of
the factor-condition distribution for factor (F1) for the two activities (Chou provides further details [19]).
6. Example
To demonstrate the benefits of SimSAFE, this section applies SimSAFE to a high-tech facility construction project in northern Taiwan. The project includes a central utility building (CUB) and a fabrication building (FAB). The total
floor area is 100,255 m2. The main CUB and FAB structures
are made of reinforced concrete (RC) and steel reinforced concrete (SRC), respectively. Both buildings require foun-dations, structure, interior finishing and wall decoration.

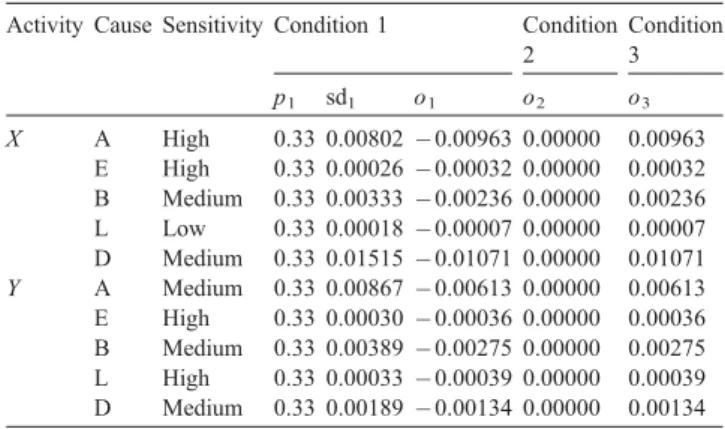

Fig. 4 illustrates the simplified schedule network, which includes 15 activities (A1 – A15), and the logical relation-ships among the various project activities. The figure also displays the five major working zones for this project, including zone 1 (foundation for CUB; including A1 – A4), zone 2 (bottom RC structure for CUB; including A5 and A6), zone 3 (foundation for FAB; including A7 and A8), zone 4 (SRC for FAB; including A9 – A11) and zone 5 (finishing and decoration for both CUB and FAB; including
A12 – A15).Table 9 also lists the duration of each activity
and the number of workers involved. 6.1. Inputs and evaluations
Table 10 shows the three-point estimations of the likelihood for each cause in association with each activity.
Based on Eqs. (2) and (3),Table 10also lists the values of
Mi( j)and ri( j)of the overall distribution due to each cause.
Three factors are considered in the example, including Table 7
Variance of factor distribution due to each cause (two-activity example) Activity Cause Variance
(ri ( j )2 )
Variance of factor distribution (SDi ( j ,k )2 )
F1 F2 F3 X A 0.00022061 0.00012606 0.00001576 0.00007879 E 0.00000031 0.00000014 0.00000009 0.00000009 B 0.00004441 0.00001480 0.00001480 0.00001480 L 0.00000037 0.00000004 0.00000004 0.00000029 D 0.00042854 0.00030610 0.00006122 0.00006122 Y A 0.00028061 0.00010022 0.00002004 0.00016035 E 0.00000039 0.00000017 0.00000011 0.00000011 B 0.00005649 0.00002017 0.00000403 0.00003228 L 0.00000047 0.00000021 0.00000013 0.00000013 D 0.00001338 0.00000478 0.00000096 0.00000765 Table 8
Properties of factor-condition distribution due to factor F1 (two-activity example)
Activity Cause Sensitivity Condition 1 Condition 2 Condition 3 p1 sd1 o1 o2 o3 X A High 0.33 0.00802 0.00963 0.00000 0.00963 E High 0.33 0.00026 0.00032 0.00000 0.00032 B Medium 0.33 0.00333 0.00236 0.00000 0.00236 L Low 0.33 0.00018 0.00007 0.00000 0.00007 D Medium 0.33 0.01515 0.01071 0.00000 0.01071 Y A Medium 0.33 0.00867 0.00613 0.00000 0.00613 E High 0.33 0.00030 0.00036 0.00000 0.00036 B Medium 0.33 0.00389 0.00275 0.00000 0.00275 L High 0.33 0.00033 0.00039 0.00000 0.00039 D Medium 0.33 0.00189 0.00134 0.00000 0.00134
safety training (F1), site environment (F2), and subcon-tractor safety management ability (F3). (Again, the number
of factors is not restricted in SimSAFE.)Table 11lists the
sensitivity of each factor on the occurrence of each cause for
each activity. Additionally,Table 12 shows the qualitative
estimates of the chances of various types of injury occurring due to each cause for each activity.
6.2. Results
The inputs were processed and simulated for 1000
iterations. Table 13 presents the expected accident cost
(Hi) associated with each activity. The table also lists the
mean occurrence of accident due to all causes for all factors
in association with each activity, and the standard deviation of accident occurrence due to all causes for a particular factor in association with each activity. Accordingly, the sensitivities of the likelihood of an accident’s occurrence to each factor can be calculated for each activity. Based on Eq.
(13),Table 14displays the sensitivities of the likelihood of
an accident’s occurrence to each factor, for each zone. 6.2.1. Managing activities
The top five activities in the example project, to which most attention should be paid to prevent accidents are
activities A14 (Hi= NT$115,046), A12 ($73,888), A5
($69,758), A9 ($54,206) and A15 ($53,821). Therefore, whenever these activities are ready to be begun or are in progress, safety inspections must be performed frequently. Moreover, in controlling the safety of each activity, the factor that dominates the occurrence of accidents must be known. For instance, activity A14 is most sensitive to F1, and then F3 and F2. Hence, improving safety training (F1) is the most effective way to control the safety of A14. 6.2.2. Managing paths
In the example project, the critical path contains activities A7, A8, A9, A10, A11, A12, A13 and A15. As well as paying attention to controlling the duration of the critical activities, management should also note that on the critical path, F1 most strongly affects the occurrence of accidents, followed by F3 and F2. Effectively ensuring that the critical activities do not involve construction accidents ensures that work can be performed smoothly. Furthermore, in this example project, a near-critical path has 16 days of float and comprises activities A7, A8, A9, A10, A11, A12 and A14. This near-critical path is most sensitive to F3, followed by F1 and F2. The expected accident cost on this near-critical path is $371,881—even higher than that on the critical path ($335,586).

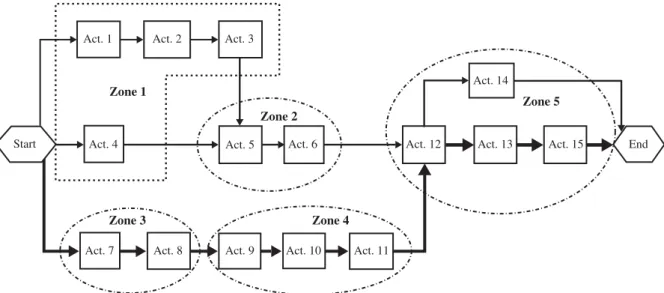

Act. 1
Act. 4
Act. 7 Act. 8 Act. 9 Act. 10 Act. 11
Act. 5 Act. 6 Act. 12 Act. 13 Act. 15
Act. 14 End Act. 2 Act. 3 Start Zone 1 Zone 2 Zone 4 Zone 5 Zone 3
Fig. 4. Simplified schedule network for example project.
Table 9
Duration of, and number of workers involved in, each activity of the example project Activity number Description Duration (days) Number of workers involved 1 Excavation (CUB) 24 20
2 Anchored retaining walls (CUB) 18 15
3 Reinforced-rebar piling (CUB) 20 15
4 Steel piling (CUB) 12 8
5 Installing reinforced rebars and forming (basement, CUB and FAB )
45 30
6 Concreting (basement, CUB and FAB) 29 10
7 Reinforced-rebar piling (FAB) 23 18
8 Foundation 20 24
9 Steel erection (FAB) 55 15
10 Deck erection (FAB) 26 15
11 Concreting (FAB) 34 8
12 Installing reinforced rebars and forming (upper structure, CUB)
130 42
13 Concreting (upper structure, CUB) 76 16
14 Interiors (CUB and FAB) 113 55
6.2.3. Managing working zones
Construction safety sometimes is managed by working zones. In the example project, zone 5 has the greatest hazard
(expected accident cost = $269,287), followed by zone 4 ($145,374), zone 1 ($103,398), zone 3 ($70,911) and zone 2 ($58,615). In managing zone 5, activity A14 has the most serious hazard. Additionally, the factor sensitivities inTable
14 reveal the key zones in managing the performance of a
particular factor. That is, F1 is most sensitive to zone 4; F2 is most sensitive to zone 1, and F3 is most sensitive to zone 4. Table 10
Three-point estimates, mean and standard deviation of the likelihood for each cause in association with each activity
Activity Cause Likelihood Pessimistic Most
Likely
Optimistic Mean Standard
deviation 1 A H SL L 0.061704 0.033503 B AS SL L 0.022340 0.005010 F H AS SL 0.011441 0.004278 H SH AS SL 0.053877 0.013589 2 A SH AS L 0.053604 0.016751 B AS SL L 0.016755 0.003758 E EH H SH 0.003998 0.000625 F H AS L 0.008362 0.003618 3 A L SL EL 0.031984 0.001675 D SH AS L 0.011706 0.003658 F SH AS L 0.007719 0.002412 4 D AS SL EL 0.004245 0.001171 F AS SL L 0.002868 0.000643 5 A SL L EL 0.054855 0.009046 B H AS L 0.052109 0.022547 D AS SL EL 0.015920 0.004390 H H AS SL 0.087365 0.032664 L SH AS EL 0.004307 0.001506 O SL L EL 0.000229 0.000038 6 E H AS L 0.001444 0.000625 N H AS L 0.000040 0.000017 7 A L SL EL 0.038381 0.002010 D SH AS L 0.014047 0.004390 F SH AS L 0.009263 0.002895 8 B H AS L 0.041687 0.018038 D AS SL L 0.013048 0.002927 E SL L EL 0.001637 0.000270 H SH SL L 0.049040 0.019647 9 A H AS SL 0.059590 0.022279 D AS SL L 0.008155 0.001829 L SH SL L 0.001708 0.000684 10 A H AS SL 0.059590 0.022279 D AS SL L 0.008155 0.001829 L SH AS L 0.002190 0.000684 11 A H AS L 0.030971 0.013401 D AS SL EL 0.004245 0.001171 12 A AS SL L 0.104564 0.023452 B SL L EL 0.034456 0.005682 D SH SL L 0.025566 0.010243 H AS SL L 0.076651 0.017191 L SH SL L 0.004783 0.001916 O H AS SL 0.000696 0.000260 13 A SL L EL 0.029256 0.004824 E H AS SL 0.002370 0.000886 N SL L EL 0.000030 0.000005 14 A SH AS L 0.196549 0.061421 H H SH SL 0.208195 0.059883 K SH AS L 0.003046 0.000952 L SH AS SL 0.008258 0.002083 O H SH AS 0.001230 0.000256 15 A SH SL EL 0.081836 0.036853 D AS SL L 0.016310 0.003658
EH—extremely higher; H—higher; SH—slightly higher; AS—almost the same as; L—lower; EL—extremely lower.
Table 11
Sensitivity of each factor on the occurrence of each cause for each activity
Activity Cause Sensitivity
Factor 1 Factor 2 Factor 3
1 A Low High Medium
B Low High Medium
F Medium High Low
H High Medium Low
2 A Medium High Low
B Medium Medium Medium
E Low High Medium
F Low High Medium
3 A Medium High Low
D High Low Medium
F High Low Medium
4 D High Low Medium
F High Low Medium
5 A High Low Medium
B Low High Medium
D High Low Medium
H High Low Medium
L Medium Low High
O High Low Medium
6 E Medium Low High
N Medium No High
7 A Medium High Low
D High Low Medium
F High Low Medium
8 B Medium High Low
D High Low Medium
E High Low Medium
H Medium High Low
9 A Medium Low High
D Medium Low High
L High Low Medium
10 A High Low Medium
D High Low Medium
L Medium Low High
11 A Low High Medium
D Medium Low High
12 A High Low Medium
B Low High Medium
D High Low Medium
H High Low Medium
L Medium Low High
O High Low Medium
13 A Low Medium High
E Medium Low High
N Medium No High
14 A Medium Low High
H High Medium Low
K High Low Medium
L Medium Low High
O Medium Low High
15 A Medium Low High
6.2.4. Managing the project
The project is most sensitive to F1, followed by F3 and F2. Effective safety training is most important for prevent-ing accidents in this example project. Additionally, the total Table 12
Qualitative estimates of the chances of various types of injury occurring due to each cause for each activity
Activity Cause Chance
Light injury Medium injury Severe injury Disabling injury Death 1 A H VH M L VL B H VH L L VL F H VH L L VL H VH H L VL VL 2 A L VH H L VL B M H L VL VL E L M H H L F VL M VH H L 3 A VL L H M L D L M VH M VL F VL H VH M L 4 D L VH H L VL F M H VH L VL 5 A M VH M L VL B VH H M L VL D H VH M L VL H VH H M L VL L VL L H M VL O VL L VH H M 6 E VL L VH H M N H VH M L VL 7 A VL L H M L D L M VH M VL F VL H VH M L 8 B H VH M L VL D M VH H L VL E M H VH L VL H H VH M L VL 9 A VL VL M H VH D VL L VH H M L M H VH L VL 10 A VL VL M H VH D VL L VH H M L M H VH L VL 11 A VL VL M H VH D VL L VH H M 12 A M VH M L VL B VH H M L VL D H VH M L VL H VH H M L VL L VL L H M VL O VL L VH H M 13 A M VH M L VL E VL L VH H M N H VH M L VL A M VH M L VL 14 H VH H M L VL K L M VH H L L VL L H M VL O VL L VH H M 15 A VL VL M H VH D VL H VH M L
VH—very high; H—high; M—medium; L—low; VL—very low.
Table 13
Expected accident costs and sensitivities to factors for each activity Activity Expected
accident cost
Factors Accident occurrence Standard deviation (1) Mean (2) CV (1)/(2) Rank A1 22,656 F1 0.012 0.085 0.141 3 F2 0.020 0.235 1 F3 0.018 0.212 2 A2 31,490 F1 0.009 0.056 0.161 2 F2 0.010 0.179 1 F3 0.005 0.089 3 A3 28,853 F1 0.003 0.043 0.070 1 F2 0.001 0.023 3 F3 0.002 0.047 2 A4 1228 F1 0.002 0.005 0.400 1 F2 0.000 0.000 3 F3 0.001 0.200 2 A5 69,758 F1 0.019 0.136 0.140 2 F2 0.015 0.110 3 F3 0.021 0.154 1 A6 33 F1 0.001 0.010 0.100 2 F2 0.000 0.000 3 F3 0.002 0.200 1 A7 38,072 F1 0.004 0.051 0.078 1 F2 0.002 0.039 3 F3 0.003 0.059 2 A8 13,533 F1 0.014 0.059 0.237 2 F2 0.015 0.254 1 F3 0.007 0.119 3 A9 54,206 F1 0.011 0.041 0.268 2 F2 0.006 0.146 3 F3 0.012 0.293 1 A10 43,288 F1 0.013 0.043 0.302 1 F2 0.006 0.140 3 F3 0.012 0.279 2 A11 24,951 F1 0.003 0.018 0.167 3 F2 0.008 0.444 1 F3 0.007 0.389 2 A12 73,888 F1 0.007 0.181 0.039 3 F2 0.008 0.044 2 F3 0.016 0.088 1 A13 18,124 F1 0.001 0.025 0.040 3 F2 0.002 0.080 2 F3 0.003 0.120 1 A14 115,046 F1 0.044 0.280 0.157 1 F2 0.035 0.125 3 F3 0.036 0.129 2 A15 53,821 F1 0.018 0.053 0.340 2 F2 0.009 0.170 3 F3 0.019 0.358 1 Table 14
Sensitivities of the likelihood of an accident’s occurrence to each factor for each zone Zones Sensitivity F1 F2 F3 Zone 1 0.079 0.116 0.095 Zone 2 0.136 0.107 0.150 Zone 3 0.125 0.125 0.071 Zone 4 0.165 0.107 0.175 Zone 5 0.095 0.069 0.086
expected cost of accidents for the entire project is $589,788, indicating the amount of contingency required for dealing with potential accidents.
7. Conclusions
This investigation presents an innovative simulation-based safety evaluation model (SimSAFE) that is integrated with the network schedule of a construction project. SimSAFE has two sources of theoretical strength. First, using qualitative model inputs is more practical than directly using quantitative inputs because practitioners are more familiar with qualitative estimates. Second, the uncertainty of an accident cause occurring is systematically disaggre-gated by safety factors and factor conditions according to a two-breakdown structure. This systematic structure eases the assessment of the influences of individual factors on accident occurrence.
Unlike earlier studies on integrating safety into planning, SimSAFE formally assesses the uncertainty in occurrence of causes of accidents (caught in and stuck by) and the hazards associated with each activity. It also explicitly combines safety information to schedule networks. Therefore, safety alerts can be proactively implemented at each time during the project. Moreover, the advantages of SimSAFE can be enhanced if it is applied to multiple projects with many activities. In that case, the efficiency of safety inspection will increase substantially, because a safety inspector or safety division (having a limited number of inspectors) can attend to highly sensitive activities, paths, zones and projects at any time.
Although the model inputs are designed to be qualitative (Tables 10, 11 and 12); the implementation of the model is found to be time-consuming. A user-friendly computer interface must be devised to simplify the use of SimSAFE in the future. Furthermore, additional historical data can be used to update the reference likelihood of each cause
occurring (Table 1), as well as updating the historical
accident costs for each accident cause (Table 3).
Acknowledgements
The writers would like to thank the reviewers for their careful evaluation and thoughtful comments. The authors also thank the National Science Council of Taiwan for financially supporting this research under Contract No. NSC-90-2211-E-009-055. Professor S. C. Huang from the National Chiao Tung University is also appreciated for his valuable assistance.
References
[1] E.J. Jaselskis, G.A.R. Suazo, A survey of construction site safety in Honduras, Constr. Manag. Econ. 12 (1994) 245 – 255.
[2] S. Salminen, Serious occupational accidents in the construction industry, Constr. Manag. Econ. 13 (1995) 299 – 306.
[3] C.M. Tam, I.W.H. Fung, Effectiveness of safety management strategies on safety performance in Hong Kong, Constr. Manag. Econ. 16 (1998) 49 – 55.
[4] CLA, Occupational Accidents in 1999¨2001 (in Chinese), Council of Labor Affairs, Executive Yuan, Taiwan, 2002.
[5] T.A. Saurin, C.T. Formoso, L.B.M. Guimaraes, Safety and production: an integrated planning and control model, Constr. Manag. Econ. 22 (2004) 159 – 169.
[6] N.A. Kartam, Integrating safety and health performance into construction CPM, J. Constr. Eng. Manag., ASCE 123 (2) (1997) 121 – 126.
[7] J. Hinze, C. Pederson, J. Fredley, Identifying root causes of construction injuries, J. Constr. Eng. Manag., ASCE 124 (1) (1998) 67 – 71.
[8] E. Sawacha, S. Naoum, D. Fong, Factors affecting safety performance on construction sites, Int. J. Proj. Manag. 17 (5) (1999) 309 – 315. [9] D.P. Fang, F. Xie, X.Y. Huang, H. Li, Factors analysis-based studies on construction workplace safety management in China, Int. J. Proj. Manag. 22 (2004) 43 – 49.
[10] A. Laufer, W.B. Ledbetter, Assessment of safety performance measures at construction sites, J. Constr. Eng. Manag., ASCE 112 (4) (1986) 530 – 542.
[11] J. Hinze, D.C. Bren, N. Piepho, Experience modification rating as measure of safety performance, J. Constr. Eng. Manag., ASCE 121 (4) (1995) 455 – 458.
[12] J.M. de la Garza, D.E. Hancher, L. Decker, Analysis of safety indicators in construction, J. Constr. Eng. Manag., ASCE 124 (4) (1998) 312 – 314.
[13] A.R. Duff, I.T. Robertson, R.A. Phillips, M.D. Cooper, Improving safety by the modification of behaviour, Constr. Manag. Econ. 12 (1994) 67 – 78.
[14] E.J. Jaselskis, S.D. Anderson, J.S. Russell, Strategies for achieving excellence in construction safety performance, J. Constr. Eng. Manag., ASCE 122 (1) (1996) 61 – 70.
[15] J. Hinze, L.L. Appelgate, Costs of construction injuries, J. Constr. Eng. Manag., ASCE 117 (3) (1991) 537 – 550.
[16] J.G. Everett, P.B. Frank, Cost of accidents and injuries to the construction industry, J. Constr. Eng. Manag., ASCE 122 (2) (1996) 158 – 164.
[17] J. Gambatese, J. Hinze, Designing for construction worker safety, Autom. Constr. 8 (1999) 643 – 649.
[18] J.J. Moder, C.R. Philips, E.W. Davis, Project Management with CPM, PERT and Precedence Diagramming, 3rd edition, Van Nostrand Reinhold, New York, 1983.
[19] S.C. Chou, Proactive Safety Management Model for Integrating Construction accidents and Schedules, MS thesis (in Chinese), National Chiao Tung University, Taiwan, 2002.
[20] W.C. Wang, L.A. Demsetz, Model for evaluating networks under correlated uncertainty—NETCOR, J. Constr. Eng. Manag., ASCE 126 (6) (2000) 458 – 466.
[21] IOSH, Investigation of Occupational Accident Cost for the Taiwan’s Construction Industry (in Chinese), Research Report, Institute of Occupational Safety and Health (IOSH) (1995).
[22] J.C. Martinez, STROBOSCOPE: State and resource based simulation of construction processes, PhD dissertation, University of Michigan, Ann Arbor, Mich., 1996.
